Supplier capability assessment in drinkware customization is frequently treated as a binary decision—either a supplier can do the work or they cannot—when the actual situation is far more nuanced. A supplier may be capable of executing simple customizations but completely unprepared for complex multi-step processes. A supplier may have equipment that can technically perform a specific printing technique but lack the process expertise to execute it consistently. A supplier may have successfully completed similar projects in the past but lack the quality control infrastructure to catch defects before they are shipped. The failure to conduct a thorough capability assessment before committing to a project is one of the most common causes of customization failures, yet it remains one of the most frequently overlooked steps in the procurement process.

The distinction between supplier capacity and supplier capability creates confusion that leads to poor supplier selection decisions. Capacity refers to the supplier's ability to produce the required volume within the required timeline—do they have enough production equipment, labor, and material supply to manufacture 10,000 units in 6 weeks? Capability refers to the supplier's ability to execute the specific technical requirements of the customization—can they produce multi-color artwork with color accuracy within Delta E 3, apply special finishes without defects, integrate custom packaging, and meet compliance requirements? A supplier may have abundant capacity but lack the capability to execute complex customizations. Conversely, a supplier may have high capability for specific customization techniques but lack the capacity to scale production to the required volume. Procurement teams that conflate capacity with capability frequently select suppliers that can produce the volume but cannot execute the quality, resulting in projects that are completed on time but with unacceptable quality.

In practice, this is often where supplier capability assessment decisions start to be misjudged—procurement teams assume that a supplier's past success on one project indicates capability for all future projects, without recognizing that customization requirements vary dramatically across projects. A supplier that successfully executed a simple single-color logo printing project may lack the capability to execute a complex multi-color artwork project with special finishes. A supplier that has experience with standard drinkware materials may lack the capability to work with specialty materials or custom colors. A supplier that has managed small customization orders may lack the organizational infrastructure to manage large orders with multiple stakeholders and approval cycles. The procurement team must conduct a capability assessment that is specific to the requirements of the current project, not based on assumptions about the supplier's general capabilities.

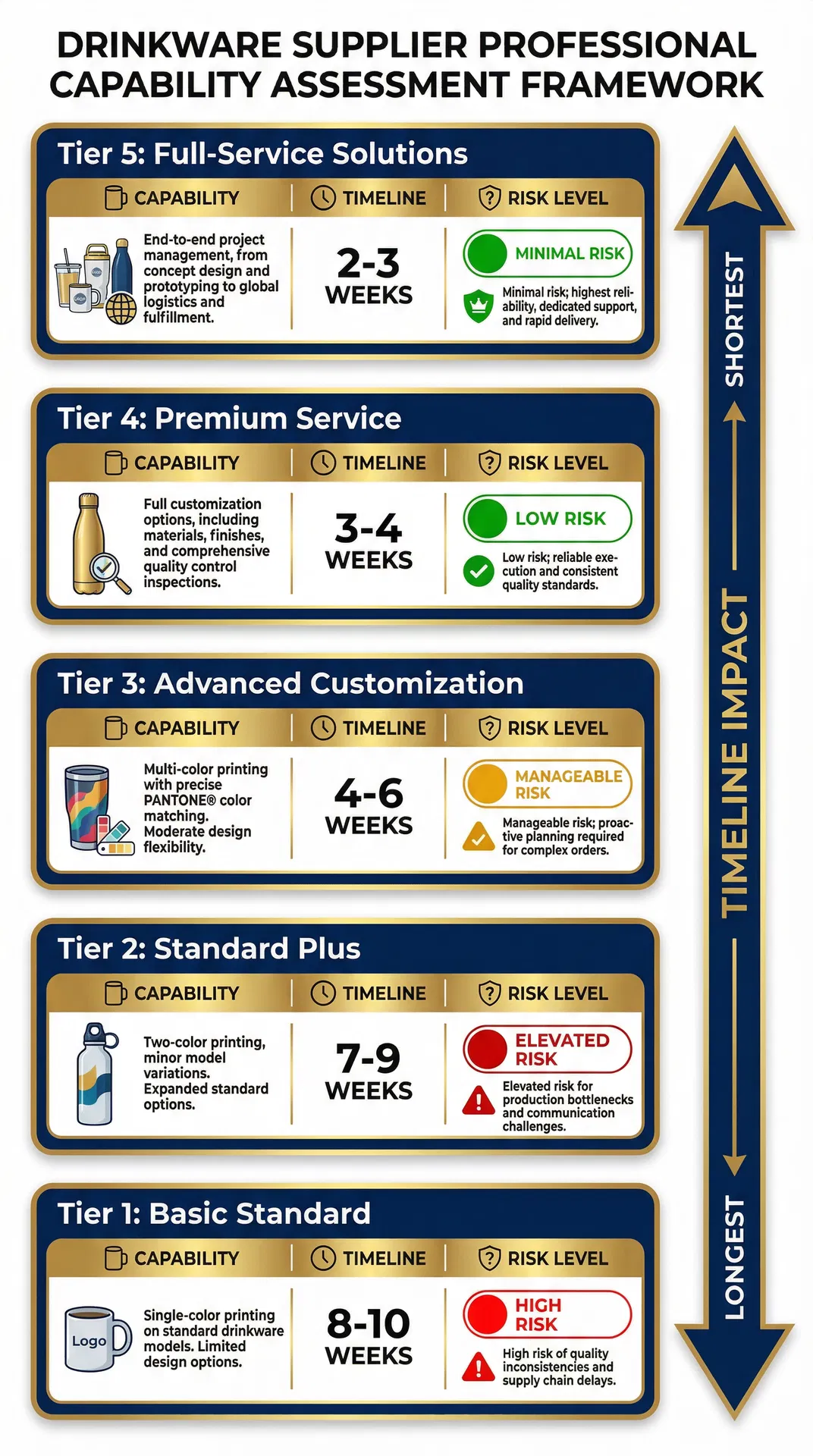

Supplier capability assessment framework showing five tiers from Basic Standard (single-color printing) to Full-Service Solutions (end-to-end customization), with timeline impact from 8-10 weeks for Tier 1 to 2-3 weeks for Tier 5
Supplier capability tiers directly impact project timeline and risk. Tier 1 suppliers (basic standard) require 8-10 weeks and carry high risk. Tier 3+ suppliers (advanced customization) deliver in 4-6 weeks with manageable risk. Tier 5 suppliers (full-service) complete projects in 2-3 weeks with minimal risk.

The components of supplier capability assessment must be tailored to the specific customization requirements of the project. For a project that requires multi-color printing with color accuracy, the capability assessment should evaluate whether the supplier has color matching equipment (spectrophotometer), whether they have documented color standards and processes, whether they have experience with the specific printing technique (screen printing, digital printing, etc.), and whether they have a track record of maintaining color consistency across production runs. For a project that requires special finishes (matte, gloss, metallic, etc.), the capability assessment should evaluate whether the supplier has the equipment to apply the finish, whether they have quality control processes to verify finish consistency, and whether they have experience with the specific finish type. For a project that requires integrated packaging and labeling, the capability assessment should evaluate whether the supplier has packaging equipment, whether they have labeling capabilities, and whether they have experience managing the coordination between multiple production steps.

The assessment of supplier quality control infrastructure is often overlooked but is critical to understanding whether a supplier can consistently deliver quality products. A supplier may have the equipment and technical expertise to execute a customization correctly, but if they lack quality control processes to verify that the customization meets specifications, defects will be released to production. The capability assessment should evaluate whether the supplier has inspection processes at each production step, whether they have measurement equipment to verify dimensions and tolerances, whether they have color matching equipment to verify color accuracy, and whether they have a documented process for identifying and addressing defects. A supplier that lacks this quality control infrastructure will inevitably produce defects, regardless of their technical expertise.

The assessment of supplier communication and project management capabilities is essential for understanding whether the supplier can successfully coordinate complex projects with multiple stakeholders. A supplier may have high technical capability but poor communication skills, resulting in specification misunderstandings and project delays. The capability assessment should evaluate whether the supplier has a dedicated project manager for the account, whether they have a process for communicating project status and issues, whether they have a process for managing change requests and approvals, and whether they have a track record of meeting deadlines and responding to urgent requests. A supplier that lacks these project management capabilities will struggle to coordinate complex customization projects, even if they have the technical expertise to execute the work.

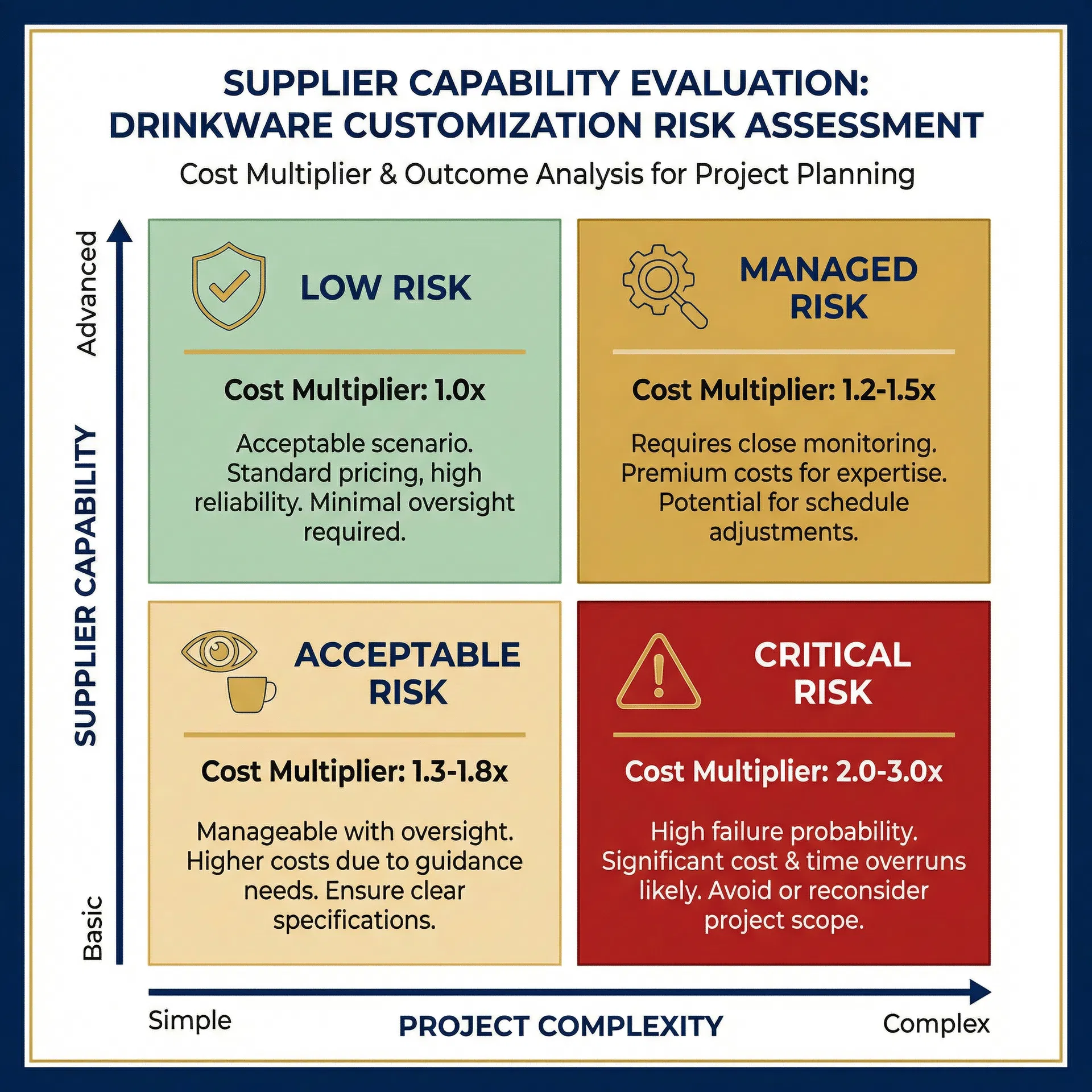

2x2 risk assessment matrix showing supplier experience level vs customization complexity, with quadrants showing critical risk (60-80% failure rate, 1.5-2.0x cost), managed risk (10-20% failure rate, 1.2x cost), acceptable risk (5-10% failure rate, 1.0x cost), and low risk (<5% failure rate, 0.9x cost)
Risk assessment matrix shows how supplier experience and customization complexity combine to determine project risk. Critical risk scenarios (limited experience + complex customization) have 60-80% failure rates and 1.5-2.0x cost multipliers. Low risk scenarios (extensive experience + simple customization) have less than 5% failure rates and 0.9x cost multipliers.

The cost implications of supplier capability mismatches are substantial and often underestimated. When a procurement team selects a supplier based on price without conducting a thorough capability assessment, they frequently discover mid-project that the supplier lacks the capability to execute the customization correctly. At that point, the options are limited: accept the defective product, pay for rework, or restart the project with a different supplier. Each of these options is expensive. Accepting a defective product damages brand reputation and customer satisfaction. Rework costs typically add 30-50% to the original project cost and delay delivery by 2-4 weeks. Restarting with a different supplier adds 4-8 weeks to the timeline and requires paying for a new production run. A supplier capability assessment that costs $1,000-$5,000 and adds 1-2 weeks to the project timeline can prevent these much larger costs.

The procurement team's role in managing supplier capability gaps must be proactive rather than reactive. If the capability assessment reveals that the supplier lacks capability in a specific area, the procurement team has several options: work with the supplier to develop the capability through training or equipment investment, reduce the scope of customization to match the supplier's current capability, or select a different supplier with higher capability. The worst option is to proceed with the project despite known capability gaps, hoping that the supplier will figure it out. This approach almost always results in project failures.

The documentation of supplier capability assessments provides valuable information for future supplier selection decisions and for managing supplier performance over time. Recording what capabilities were assessed, what gaps were identified, and how they were addressed creates a supplier capability profile that improves decision-making on future projects. A procurement team that has documented "Supplier A has high capability for multi-color printing but lacks capability for special finishes" will make different supplier selection decisions for future projects than a team that has no capability data. Without this documentation, the same capability gaps are discovered repeatedly across projects, resulting in repeated project failures and wasted resources.
