Artwork File Handover vs Internal Approval in Drinkware Customization
Why buyers conflate internal approval completion with artwork finalization, and how this creates costly rework fees and delays
When corporate buyers commission custom drinkware with branded artwork—a company logo on stainless steel tumblers, a product label on glass bottles, or a promotional design on ceramic mugs—they typically follow an internal approval workflow. Marketing reviews the design for brand consistency. Legal checks for trademark compliance. The compliance team verifies that regulatory text meets FDA or EU requirements. Once all internal stakeholders sign off, the buyer considers the artwork "finalized" and ready to share with the factory. In practice, this is often where customization process decisions start to be fundamentally misjudged, because the buyer's definition of "final artwork" and the factory's interpretation of "production-ready files" operate on completely different timelines and carry entirely different consequences.
The confusion stems from how buyers conceptualize the artwork approval process. In their mental model, sharing files with the factory is a collaborative step—a way to get the supplier's input on technical feasibility, print quality, or color matching before committing to production. This framing is reinforced by the fact that many factories explicitly request artwork files "for review" or "to provide an accurate quote." From the buyer's perspective, sending files at this stage is exploratory, not binding. They assume they retain full control to make revisions, incorporate feedback from additional stakeholders, or adjust regulatory text as compliance requirements evolve. The factory, however, interprets file receipt very differently. The moment production-intent artwork lands in their system, they begin irreversible processes: creating print plates, programming laser engraving machines, mixing custom Pantone ink colors, and scheduling production runs. These activities generate costs and lock in specifications. What the buyer views as a "preliminary file for discussion" becomes, in the factory's workflow, the baseline for all subsequent production setup.

The structural issue is that buyers treat artwork finalization as an internal governance milestone—a point at which their own stakeholders have reached consensus—while factories treat file receipt as an external commitment that triggers capital-intensive preparation. This misalignment is invisible during the initial quoting phase. When a buyer requests a quote for 10,000 custom-branded water bottles, the factory asks for artwork files to assess complexity: How many colors will require separate print passes? Does the logo include fine detail that demands high-resolution laser engraving? Are there gradients or halftones that need specialized screening? The buyer provides the files, believing this is standard due diligence. The factory receives the files and begins work. They create a digital proof, generate separation films for screen printing, and order custom ink batches matched to the buyer's brand colors. By the time the buyer's compliance team identifies a missing allergen warning or a legal team flags an outdated trademark symbol, the factory has already invested $4,000 to $12,000 in pre-production setup. Any change to the artwork now requires scrapping those plates, re-mixing inks, and restarting the entire setup process. The buyer is shocked to learn that a "minor text edit" will cost $6,500 and add three weeks to the lead time. The factory, meanwhile, is equally frustrated that the buyer sent "production files" without completing their internal approvals.

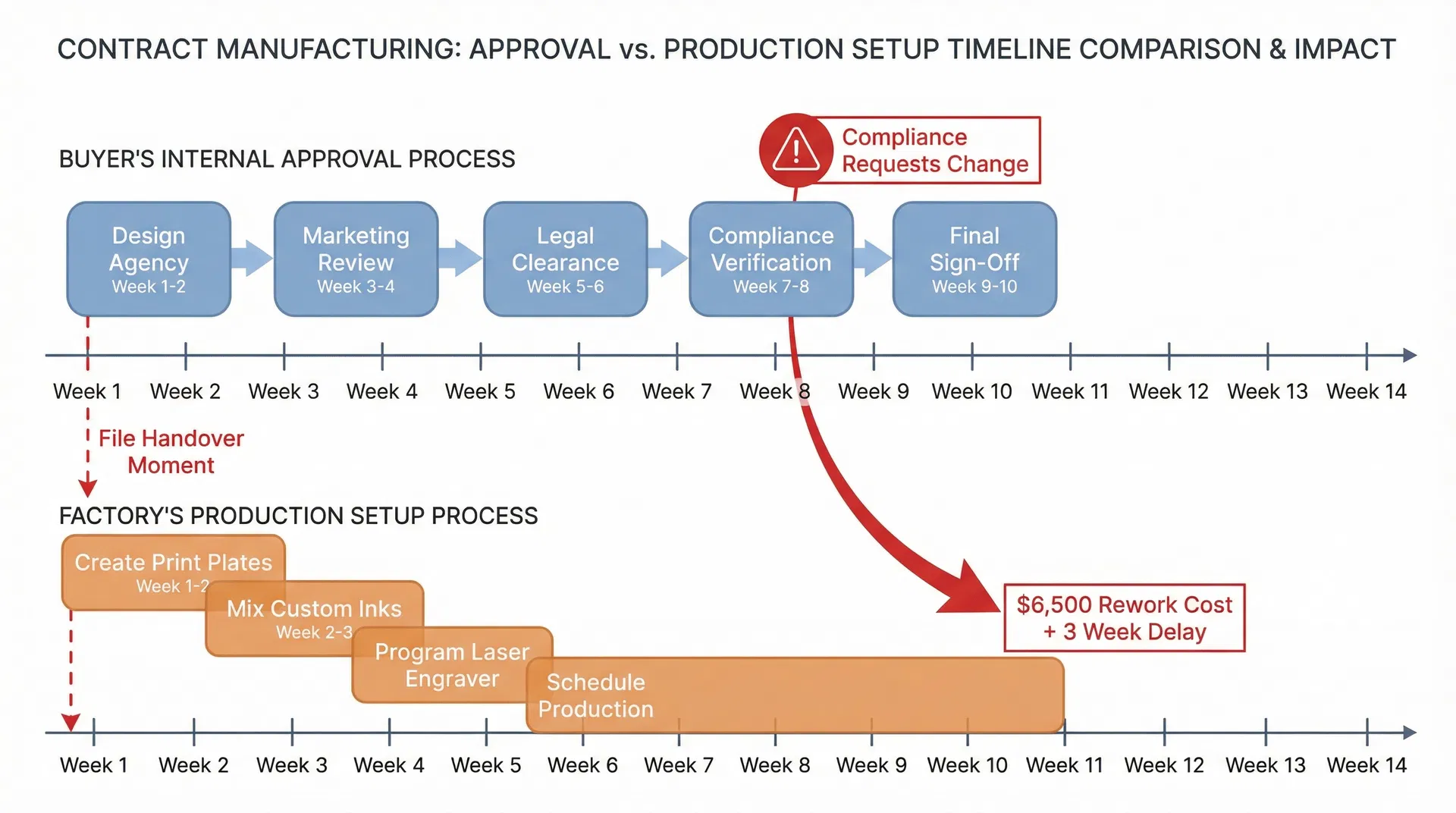

What makes this blind spot particularly persistent is that it is reinforced by the buyer's own internal processes. Most organizations have formal artwork approval workflows designed to ensure quality and compliance. A typical process might involve five stages: initial design by an agency, review by the marketing team, legal clearance for trademarks and claims, compliance verification for regulatory text, and final sign-off by a senior stakeholder. This workflow can take four to eight weeks, depending on the organization's complexity and the number of revision cycles. During this period, the buyer is focused on internal coordination—chasing approvals, resolving conflicting feedback, and ensuring that every stakeholder's concerns are addressed. The factory's timeline, however, does not pause during this internal deliberation. If the buyer provided artwork files at the quoting stage, the factory has already begun production setup based on those files. The buyer's internal approval process is happening in parallel with the factory's pre-production work, but the buyer is unaware of this overlap because they have not yet given explicit authorization to proceed. They assume that until they issue a formal purchase order or send a "final approval" email, the factory is simply waiting. In reality, the factory is moving forward, treating the files they received as the definitive specification.

The economic incentive structure explains why factories behave this way. Lead times in drinkware manufacturing are competitive differentials. A factory that can promise a 45-day turnaround has a significant advantage over one that quotes 60 days. To achieve shorter lead times, factories overlap pre-production activities with the quoting and negotiation phase. They do not wait for a signed contract to begin creating print plates or mixing inks; they start as soon as they have files that appear production-ready. This approach allows them to compress the overall timeline, but it also creates financial risk. If the buyer ultimately decides not to place the order, or if they request significant artwork changes, the factory absorbs the cost of wasted setup work. To mitigate this risk, factories build "artwork change fees" into their pricing structure. These fees are not punitive; they reflect the actual cost of scrapping completed setup work and starting over. But buyers, who are unaware that setup work has already begun, perceive these fees as opportunistic price increases. They argue that they never gave final approval, so the factory should not have started production preparation. The factory counters that the buyer provided production files and requested an aggressive lead time, which required them to begin work immediately. Both parties are operating from internally consistent logic, but their assumptions about when commitment occurs are fundamentally incompatible.
The timing of when buyers recognize this blind spot is remarkably consistent: it occurs when they attempt to make what they consider a "minor" artwork revision after the factory has received the files. This might be triggered by a compliance audit that identifies missing regulatory text, a legal review that catches an outdated trademark, or a marketing decision to update the tagline. The buyer contacts the factory to request the change, expecting a straightforward file update. Instead, they receive a quote for $6,500 and a notification that the lead time will extend by three weeks. At this point, the buyer realizes that the files they sent "for review" were treated as production-locked specifications. They have paid for setup work they cannot use, and they must now decide whether to absorb the cost of rework or proceed with artwork they know contains errors or outdated information. If the issue is regulatory—such as missing allergen warnings or incorrect country-of-origin labeling—proceeding with the original artwork is not an option. The buyer must pay the rework fee and accept the delay. If the issue is cosmetic—such as a tagline update or a color adjustment—the buyer faces a difficult trade-off: pay thousands of dollars for a change that has no functional impact, or launch a product with artwork that does not fully align with their current brand guidelines.
There is also a reputational dimension. Buyers who have committed to product launch dates, signed distribution agreements, or accepted pre-orders cannot easily explain to their stakeholders why the timeline has slipped due to an artwork revision. The factory, aware of this pressure, uses it as leverage to negotiate the rework fee. They know that the buyer cannot afford to walk away, because finding a new supplier would require restarting the entire quoting and setup process, adding even more delay. The buyer, facing imminent revenue loss and contractual penalties from their own customers, often capitulates. The artwork change they thought would be a simple email request ends up costing $6,500 to $12,000, plus the opportunity cost of the delayed launch. The factory, meanwhile, views this as a fair recovery of their sunk costs. They did not create the artwork error; they simply executed the files they were given. From their perspective, the buyer's failure to complete internal approvals before sharing files is the root cause of the problem.
The broader issue is that the customization process in drinkware manufacturing front-loads file handover while back-loading the buyer's ability to verify that all internal approvals are complete. By the time the buyer's compliance team reviews the artwork and identifies missing regulatory text, the factory has already created print plates based on the incomplete files. Revising those files at this stage is not a matter of updating a digital document; it requires physical rework of tooling and materials that have already been fabricated. The buyer's internal approval process, which can take weeks or months, is invisible to the factory. The factory sees only two data points: the date they received the files, and the lead time the buyer requested. If the buyer asked for a 45-day turnaround, the factory calculates backward from the delivery date and begins setup work immediately to meet that deadline. The buyer's internal deliberations—legal reviews, compliance audits, stakeholder sign-offs—are not factored into the factory's timeline because the buyer never communicated that those processes were still ongoing.

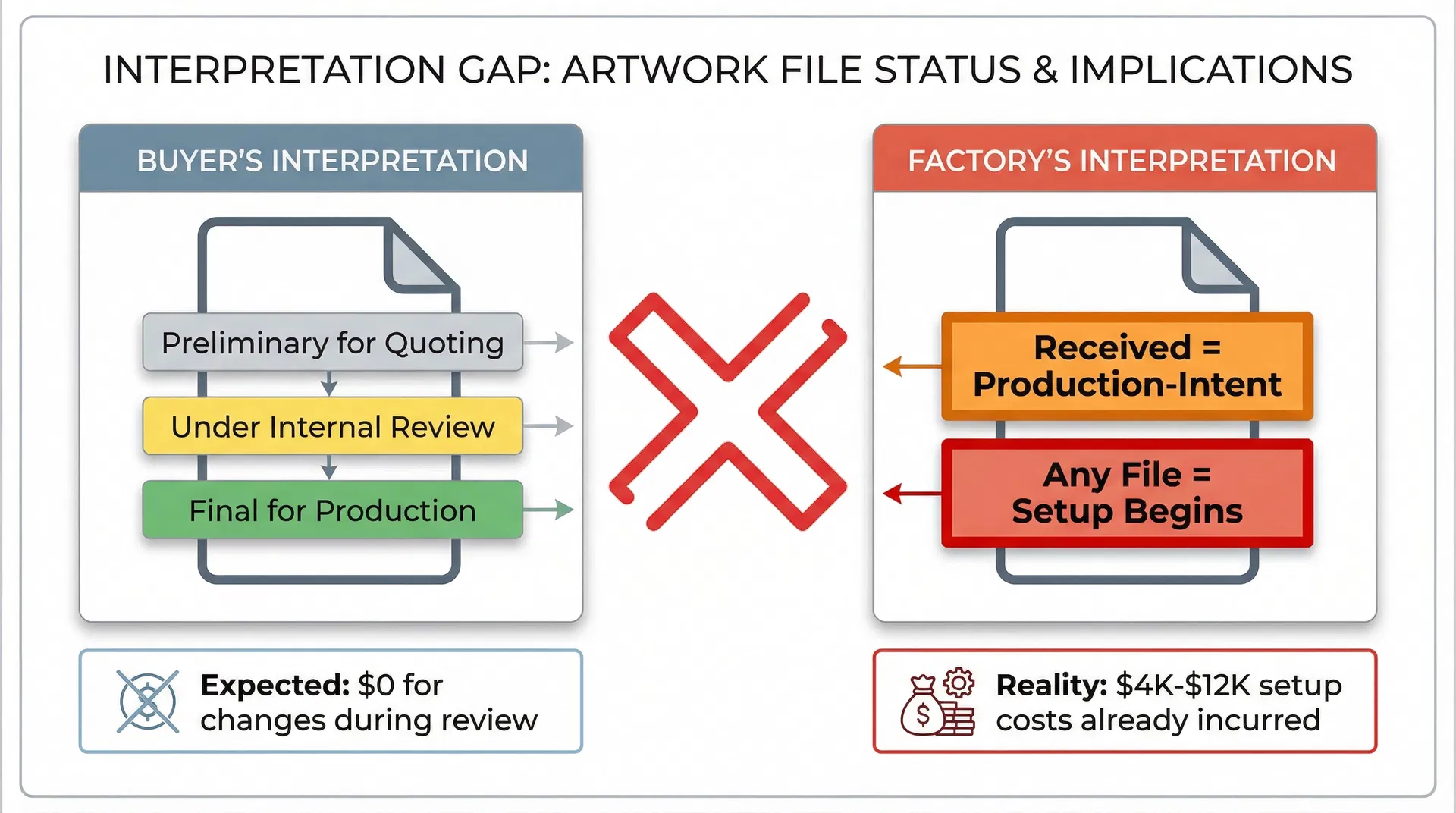

What remains unaddressed in most buyer-supplier negotiations is the question of how to establish a formal "artwork freeze point" that both parties recognize as the moment when files become production-locked. This requires more than a contract clause stating "Buyer must approve all artwork before production begins." It requires defining what "approval" means in operational terms: Does it mean the buyer's internal stakeholders have signed off? Does it mean the buyer has explicitly labeled the files as "final for production"? Does it mean the factory has sent a digital proof and the buyer has confirmed it? Without this shared definition, the buyer and factory will continue to operate from incompatible assumptions. The buyer will believe they can revise artwork until they give explicit final approval. The factory will believe that any files received are production-intent unless explicitly labeled otherwise. The gap between these assumptions creates a window of vulnerability where costly misunderstandings occur.
Even with a formal freeze point defined in the contract, the fundamental tension remains: the buyer's economic interest lies in retaining flexibility to incorporate late-stage feedback from stakeholders, while the factory's economic interest lies in locking in specifications as early as possible to compress lead times and reduce rework risk. Buyers who understand this dynamic can structure their internal approval processes to complete all stakeholder reviews BEFORE sharing files with the factory. This means conducting legal clearance, compliance verification, and marketing sign-offs during the design phase, not during the factory quoting phase. It also means explicitly labeling files as "preliminary for quoting only" when sharing them for cost estimation, and withholding production-ready files until all internal approvals are complete. Those who do not understand this dynamic will continue to conflate internal approval completion with artwork finalization, only discovering the difference when a compliance audit triggers a $6,500 rework fee and a three-week delay that jeopardizes their product launch timeline.
